Close Menu
reNEWSreNEWS
  • Home
  • Offshore Wind
  • Onshore Wind
  • Solar
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
Latest News

PODCAST: Is UK offshore wind back on track?

All-Energy 2026: Shanks bullish on UK clean power

GWEC, TÜREB launch wind partnership

LinkedIn Facebook X (Twitter)
LinkedIn Facebook X (Twitter)
  • Email Briefings
  • About
  • Advertise
  • Contact
reNEWSreNEWS
  • Home
  • Offshore Wind

    PODCAST: Is UK offshore wind back on track?

    May 13, 2026

    UK offshore wind pipeline reaches 93GW

    May 13, 2026

    Seaway7 completes Hai Long cable works

    May 13, 2026

    DEME names new jack-up vessel

    May 13, 2026

    Mubadala invests $325m into Hornsea 3

    May 13, 2026
  • Onshore Wind

    ENERCON to build Türkiye blade plant

    May 13, 2026

    ‘Fatality at South Korean wind farm’

    May 13, 2026

    Scottish onshore wind forum launches

    May 12, 2026

    ENOVA starts 30MW Hiddels repowering

    May 12, 2026

    Iberdrola buys 40MW Italian wind farm

    May 12, 2026
  • Solar

    VSB secures Sicily PV project approval

    May 13, 2026

    Matrix connects two Spanish renewable projects

    May 13, 2026

    Qualitas targets €10bn energy investments

    May 12, 2026

    Consultation opens for 49.9MW Barrons Solar

    May 12, 2026

    Great North Road solar nears decision

    May 11, 2026
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
LinkedIn Facebook X (Twitter)
reNEWSreNEWS
Home » Uncategorized » Construction work starts on BorWin kappa platform
Offshore Wind

Construction work starts on BorWin kappa platform

Eleanore RobinsonBy Eleanore RobinsonJuly 5, 20232 Mins Read
Construction work starts on BorWin kappa platform

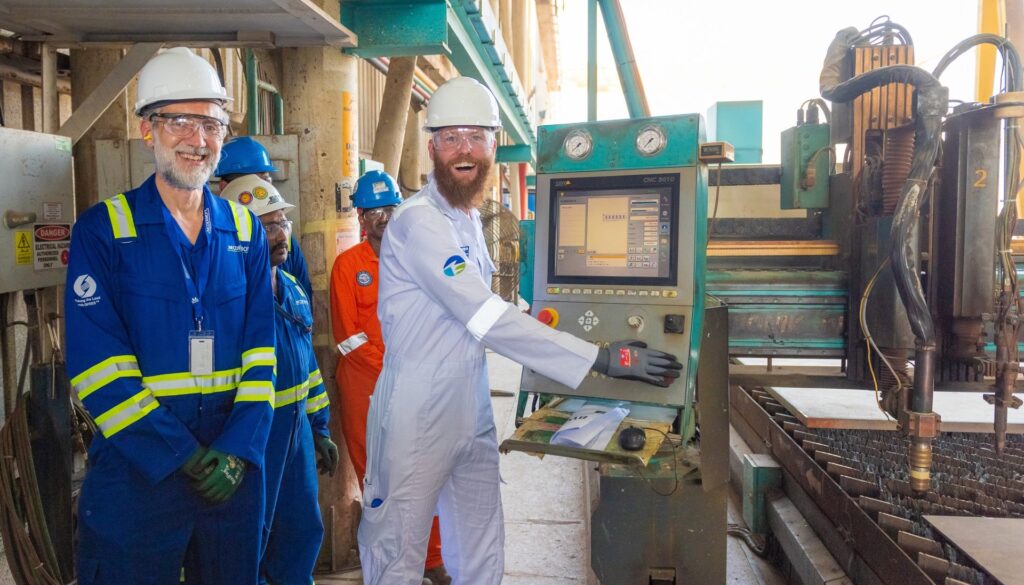

Construction on TenneT’s BorWin kappa offshore wind converter platform has begun at a shipyard in Jebel-Ali in Dubai with the first steel cut.

The BorWin kappa converter station is the starting point for the BorWin6 offshore grid connection in Germany, which will make an important contribution to the energy transition from 2027 with a grid connection capacity of 980MW.

Advertisement

The contract for the construction of the converter stations at sea and on land was awarded to the McDermott and GEIRI/C-EPRI consortium in February 2022.

The BorWin6 project will implement a high-voltage direct current (HVDC) transmission of 980MW from the offshore wind farm to the extra-high-voltage grid in Büttel (Schleswig-Holstein).

The wind power produced at sea off the coast of Lower Saxony is fed as three-phase current to TenneT’s BorWin kappa converter platform, where it is converted into direct current and transported over the 235-kilometre-long cable route to the Büttel converter station.

Here, the electricity is converted back into three-phase current and fed into the extra-high-voltage grid via the substation. Due to the distance and the power to be transmitted, direct current is suitable for low-loss transport.

The converter platform itself (topside) is placed on a substructure (jacket).

This jacket will be built in Batam (Indonesia) from September.

The topside will measure approximately 63 x 67 x 46 meters, and installation is scheduled for summer 2026.

The platform will be brought through the Suez Canal, the Mediterranean Sea and then through the Bay of Biscay to the location in the North Sea and set down on the jacket by “float-over”.

This means that the platform is positioned exactly above the jacket and then lowered precisely onto the structure.

The jacket is to be installed in the 38-metre-deep water a year earlier in the summer of 2025.

Before the end of 2023, corresponding horizontal boreholes will also be drilled to cross under the state protection dike near Büsum, and later the Kiel Canal.

The laying of the land cable will take place in 2024 and 2025, the laying of the submarine cable in 2025 and 2026.

Nexans Norway AS was commissioned to produce and install the DC cables at sea and on land.

In addition, the first preparatory measures for the land station in Büttel have been completed, and the actual construction of the land station will begin in 2024.

BorWin kappa Germany Offshore Wind Tennet
Share. Facebook LinkedIn Bluesky Twitter Reddit Email Copy Link
Previous ArticleOrsted orders second methanol-powered SOV
Next Article UAE to triple renewable energy contribution by 2030

Related News

TenneT installs 900MW BorWin converter platform

May 19, 2025

TenneT wraps up DolWin kappa installation

September 5, 2022

Siemens, NKT secure BorWin5 prizes

August 11, 2020
Advertisement

Latest News

PODCAST: Is UK offshore wind back on track?

May 13, 2026

All-Energy 2026: Shanks bullish on UK clean power

May 13, 2026

GWEC, TÜREB launch wind partnership

May 13, 2026

ENERCON to build Türkiye blade plant

May 13, 2026
Advertisement

Advertisement

Company Profiles
  • Collett & Sons Ltd
  • TGS
  • Oceantic Network
  • Navantia Seanergies
    Navantia Seanergies
  • Natural Power
    Natural Power
  • LSP
    LSP Renewables
  • JDR Cable Systems Ltd
  • Full Circle Wind Services
  • EEW
    EEW Special Pipe Constructions GmbH
  • Brightwind
    BrightWind Limited
reNEWS
LinkedIn Facebook X (Twitter)
reMIX | Company Profiles | Industry Events
Get in touch | Advertising with us | About reNEWS

© 2026 Lewis Business Media. All Rights Reserved.
Lewis Business Media, Suite A, Arun House, Office Village, River Way, Uckfield, TN22 1SL

Terms and Conditions | Privacy Policy | Cookie Policy

Type above and press Enter to search. Press Esc to cancel.

Manage Consent
To provide the best experiences, we use technologies like cookies to store and/or access device information. Consenting to these technologies will allow us to process data such as browsing behaviour or unique IDs on this site. Not consenting or withdrawing consent, may adversely affect certain features and functions.
Functional Always active
The technical storage or access is strictly necessary for the legitimate purpose of enabling the use of a specific service explicitly requested by the subscriber or user, or for the sole purpose of carrying out the transmission of a communication over an electronic communications network.
Preferences
The technical storage or access is necessary for the legitimate purpose of storing preferences that are not requested by the subscriber or user.
Statistics
The technical storage or access that is used exclusively for statistical purposes. The technical storage or access that is used exclusively for anonymous statistical purposes. Without a subpoena, voluntary compliance on the part of your Internet Service Provider, or additional records from a third party, information stored or retrieved for this purpose alone cannot usually be used to identify you.
Marketing
The technical storage or access is required to create user profiles to send advertising, or to track the user on a website or across several websites for similar marketing purposes.
  • Manage options
  • Manage services
  • Manage {vendor_count} vendors
  • Read more about these purposes
View preferences
  • {title}
  • {title}
  • {title}
