Close Menu
reNEWSreNEWS
  • Home
  • Offshore Wind
  • Onshore Wind
  • Solar
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
Latest News

PODCAST: Is UK offshore wind back on track?

All-Energy 2026: Shanks bullish on UK clean power

GWEC, TÜREB launch wind partnership

LinkedIn Facebook X (Twitter)
LinkedIn Facebook X (Twitter)
  • Email Briefings
  • About
  • Advertise
  • Contact
reNEWSreNEWS
  • Home
  • Offshore Wind

    PODCAST: Is UK offshore wind back on track?

    May 13, 2026

    UK offshore wind pipeline reaches 93GW

    May 13, 2026

    Seaway7 completes Hai Long cable works

    May 13, 2026

    DEME names new jack-up vessel

    May 13, 2026

    Mubadala invests $325m into Hornsea 3

    May 13, 2026
  • Onshore Wind

    ENERCON to build Türkiye blade plant

    May 13, 2026

    ‘Fatality at South Korean wind farm’

    May 13, 2026

    Scottish onshore wind forum launches

    May 12, 2026

    ENOVA starts 30MW Hiddels repowering

    May 12, 2026

    Iberdrola buys 40MW Italian wind farm

    May 12, 2026
  • Solar

    VSB secures Sicily PV project approval

    May 13, 2026

    Matrix connects two Spanish renewable projects

    May 13, 2026

    Qualitas targets €10bn energy investments

    May 12, 2026

    Consultation opens for 49.9MW Barrons Solar

    May 12, 2026

    Great North Road solar nears decision

    May 11, 2026
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
LinkedIn Facebook X (Twitter)
reNEWSreNEWS
Home » Uncategorized » HKZ foundation work falls behind schedule
Offshore Wind

HKZ foundation work falls behind schedule

Robin LancasterBy Robin LancasterDecember 24, 20212 Mins Read

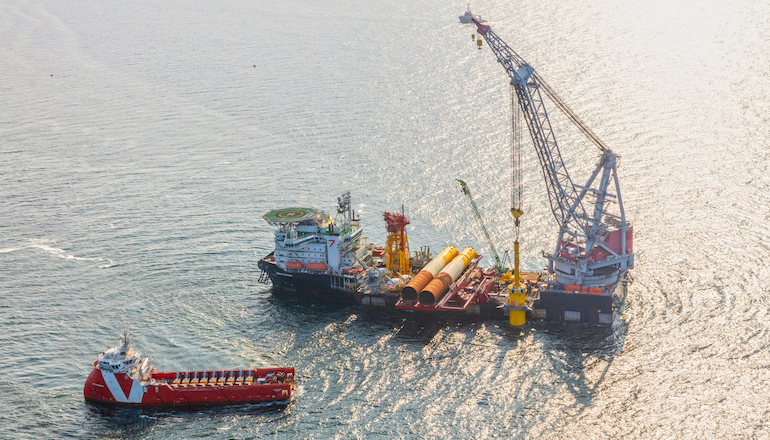

HKZ foundation work falls behind schedule

Bad weather and technical problems have put foundation installation behind schedule at Vattenfall’s 1500MW Hollandse Kust Zuid offshore wind farm off the Netherlands.

Only 34 monopiles out of the project’s 140 have been installed during the first installation campaign, which started on 5 July.

Advertisement

HKZ project director Ian Bremner said the campaign had a “challenging start, due to some unexpected technical difficulties on the foundation installation vessel” Seaway Strashnov.

He said: “However, once those were resolved and we were up and running, things went really well, and the pace of installation was meeting our expectations.

“Unfortunately, further technical difficulties interrupted the momentum and we never quite recovered the earlier performance.

“The delays pushed the works further and further into adverse weather periods to the point where it was no longer viable to continue.

“This translated into us falling short of our foundation installation target for 2021.”

Bremner added that there is flexibility in the start date of the second foundation installation campaign that should allow the project to recover the installation shortfall from the first campaign.

“This means that the early challenges do not materially impact the overall schedule,” he said.

“In fact, this first campaign has provided us with lots of opportunity to learn key lessons that we can use to plan and optimize the second campaign, which is a lot more time critical,” he added.

“We are confident that foundation installation performance will improve next year.”

The second campaign should start at the beginning of March, with the installation of the remaining 106 monopiles.

Next spring, the first cables and turbines will also be installed.

The HKZ team is using the coming winter period to prepare for this new phase, Vattenfall said.

Bremner said: “We are performing a great deal of programme analysis and detailed planning to be 100% prepared for these first connections to the substations and delivery of power to the grid.

“We have to manage some very complex interfaces between cable and turbine installation and commissioning.

“There are so many activities taking place involving so many teams and contractors, and all activities are highly interconnected.

“We are turning every stone to make sure the planning is perfect and that we have all of our risks in clear view and mitigated.”

Hollandse Kust Zuid Offshore Wind Vattenfall
Share. Facebook LinkedIn Bluesky Twitter Reddit Email Copy Link
Previous ArticleAcciona hydrogen initiative starts commissioning tests
Next Article Two US ports win funding for offshore development

Related News

HKZ foundation installation work starts in North Sea

September 1, 2021

Petrofac confirms HKZ Beta job

June 27, 2019

Vattenfall joins battle for 750MW HKZ 3&4

February 28, 2019
Advertisement

Latest News

PODCAST: Is UK offshore wind back on track?

May 13, 2026

All-Energy 2026: Shanks bullish on UK clean power

May 13, 2026

GWEC, TÜREB launch wind partnership

May 13, 2026

ENERCON to build Türkiye blade plant

May 13, 2026
Advertisement

Advertisement

Company Profiles
  • Collett & Sons Ltd
  • Seaway7
    Seaway7
  • Pembroke Port
  • Navantia Seanergies
    Navantia Seanergies
  • Natural Power
    Natural Power
  • LSP
    LSP Renewables
  • JDR Cable Systems Ltd
  • EEW
    EEW Special Pipe Constructions GmbH
  • Brightwind
    BrightWind Limited
  • Bilfinger UK
reNEWS
LinkedIn Facebook X (Twitter)
reMIX | Company Profiles | Industry Events
Get in touch | Advertising with us | About reNEWS

© 2026 Lewis Business Media. All Rights Reserved.
Lewis Business Media, Suite A, Arun House, Office Village, River Way, Uckfield, TN22 1SL

Terms and Conditions | Privacy Policy | Cookie Policy

Type above and press Enter to search. Press Esc to cancel.

Manage Consent
To provide the best experiences, we use technologies like cookies to store and/or access device information. Consenting to these technologies will allow us to process data such as browsing behaviour or unique IDs on this site. Not consenting or withdrawing consent, may adversely affect certain features and functions.
Functional Always active
The technical storage or access is strictly necessary for the legitimate purpose of enabling the use of a specific service explicitly requested by the subscriber or user, or for the sole purpose of carrying out the transmission of a communication over an electronic communications network.
Preferences
The technical storage or access is necessary for the legitimate purpose of storing preferences that are not requested by the subscriber or user.
Statistics
The technical storage or access that is used exclusively for statistical purposes. The technical storage or access that is used exclusively for anonymous statistical purposes. Without a subpoena, voluntary compliance on the part of your Internet Service Provider, or additional records from a third party, information stored or retrieved for this purpose alone cannot usually be used to identify you.
Marketing
The technical storage or access is required to create user profiles to send advertising, or to track the user on a website or across several websites for similar marketing purposes.
  • Manage options
  • Manage services
  • Manage {vendor_count} vendors
  • Read more about these purposes
View preferences
  • {title}
  • {title}
  • {title}
