Close Menu
reNEWSreNEWS
  • Home
  • Offshore Wind
  • Onshore Wind
  • Solar
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
Latest News

PODCAST: Is UK offshore wind back on track?

All-Energy 2026: Shanks bullish on UK clean power

GWEC, TÜREB launch wind partnership

LinkedIn Facebook X (Twitter)
LinkedIn Facebook X (Twitter)
  • Email Briefings
  • About
  • Advertise
  • Contact
reNEWSreNEWS
  • Home
  • Offshore Wind

    PODCAST: Is UK offshore wind back on track?

    May 13, 2026

    UK offshore wind pipeline reaches 93GW

    May 13, 2026

    Seaway7 completes Hai Long cable works

    May 13, 2026

    DEME names new jack-up vessel

    May 13, 2026

    Mubadala invests $325m into Hornsea 3

    May 13, 2026
  • Onshore Wind

    ENERCON to build Türkiye blade plant

    May 13, 2026

    ‘Fatality at South Korean wind farm’

    May 13, 2026

    Scottish onshore wind forum launches

    May 12, 2026

    ENOVA starts 30MW Hiddels repowering

    May 12, 2026

    Iberdrola buys 40MW Italian wind farm

    May 12, 2026
  • Solar

    VSB secures Sicily PV project approval

    May 13, 2026

    Matrix connects two Spanish renewable projects

    May 13, 2026

    Qualitas targets €10bn energy investments

    May 12, 2026

    Consultation opens for 49.9MW Barrons Solar

    May 12, 2026

    Great North Road solar nears decision

    May 11, 2026
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
LinkedIn Facebook X (Twitter)
reNEWSreNEWS
Home » Uncategorized » Jan De Nul completes Changhua demo export wires
Offshore Wind

Jan De Nul completes Changhua demo export wires

Robin LancasterBy Robin LancasterAugust 3, 20203 Mins Read
Jan De Nul completes Changhua demo export wires

Jan De Nul Group has completed the installation of four medium-voltage export cables for Taiwan Power’s 109MW Changhua demo offshore wind farm off the coast of the Asian island.

Cable-laying vessel Willem de Vlamingh installed the four subsea export cables from the project site, 10km off the coast, to landfall near Fangyuan.

Advertisement

Jan De Nul Group teamed up with Taiwanese partner Hung Hua Construction, which provided essential marine equipment including a jack-up barge, for the beach pull-in operations such as passing over a shallow water sandbank.

The wires had to be pulled through 1km-long underground ducts, which had previously been installed by horizontal directional drilling (HDD) up to 21 metres below the seabed, due to the presence of a nearshore oyster farm and an important shipping lane for fishermen on the cables route.

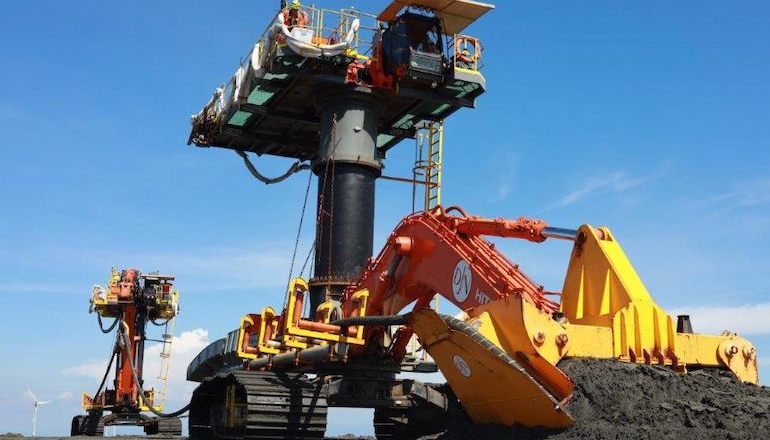

Willem de Vlamingh also acted as a trenching support vessel for the offshore work, while the nearshore trenching works, Jan De Nul’s Starfish excavators used an in-house developed plough-skid and jet-skid.

Jan De Nul Group project director Jan Kop said: “Originally, the HDD’s were stipulated in the contract to be 300 meters long, but Jan De Nul decided to extend them in order to prevent any damage to the sensitive coastal zone and fish farms.

“As such, we demonstrate once more Jan De Nul’s global care for the environment.

“Our offshore cable team did an amazing job, as did our onshore civil construction team who worked on the HDD together with Taiwanese companies Hung Hua and Magitech.”

The work also included an upgrade to the onshore substation in Changhua County, Jan De Nul said.

Together with its Taiwanese subcontractor Chung-Hsien Chen, Jan De Nul completed the installation and commissioning of new electrical equipment, including HV transformers, HV and MV switchgear, a new SCADA control room and emergency power supply, inside the onshore substation in Da Cheng.

The upgraded substation has been connected to the national grid for the first time in this new configuration, following a 24-hour energisation test.

Jan De Nul added that foundation installation of 84 pin piles and 21 jackets is making steady progress, with its consortium partner Hitachi continuing to prepare the turbines in the Taichung marshalling port.

The turbine installation campaign, due to start this month, will feature Jan De Nul’s jack-up Taillevent.

Jan De Nul Group is responsible for the full balance of plant, including design, fabrication and installation of the foundations, and the provision of the offshore vessel for the installation of the wind turbines.

Hitachi is in charge of manufacturing, assembly, installation and other works related to the 21 Typhoon certified turbines using a downwind rotor, each with a capacity of 5.2MW.

The Jan De Nul–Hitachi consortium is responsible for the first five years operation and maintenance of the TPC Changhua offshore wind farm phase 1.

Changhua Jan De Nul Offshore Wind
Share. Facebook LinkedIn Bluesky Twitter Reddit Email Copy Link
Previous ArticleEnercon JV to sell 38MW Vietnamese wind
Next Article BP unveils 50GW by 2030 renewables goal

Related News

Jan De Nul completes Taiwanese turbine job

June 23, 2021

Jan De Nul plants first jackets at Taiwan Power demo

August 13, 2020

Jan De Nul starts offshore work at 109MW Changhua

July 9, 2020
Advertisement

Latest News

PODCAST: Is UK offshore wind back on track?

May 13, 2026

All-Energy 2026: Shanks bullish on UK clean power

May 13, 2026

GWEC, TÜREB launch wind partnership

May 13, 2026

ENERCON to build Türkiye blade plant

May 13, 2026
Advertisement

Advertisement

Company Profiles
  • Collett & Sons Ltd
  • Leask Marine
  • TGS
  • Pembroke Port
  • Ørsted
  • Natural Power
    Natural Power
  • JDR Cable Systems Ltd
  • Full Circle Wind Services
  • EDF
    EDF
  • Bilfinger UK
reNEWS
LinkedIn Facebook X (Twitter)
reMIX | Company Profiles | Industry Events
Get in touch | Advertising with us | About reNEWS

© 2026 Lewis Business Media. All Rights Reserved.
Lewis Business Media, Suite A, Arun House, Office Village, River Way, Uckfield, TN22 1SL

Terms and Conditions | Privacy Policy | Cookie Policy

Type above and press Enter to search. Press Esc to cancel.

Manage Consent
To provide the best experiences, we use technologies like cookies to store and/or access device information. Consenting to these technologies will allow us to process data such as browsing behaviour or unique IDs on this site. Not consenting or withdrawing consent, may adversely affect certain features and functions.
Functional Always active
The technical storage or access is strictly necessary for the legitimate purpose of enabling the use of a specific service explicitly requested by the subscriber or user, or for the sole purpose of carrying out the transmission of a communication over an electronic communications network.
Preferences
The technical storage or access is necessary for the legitimate purpose of storing preferences that are not requested by the subscriber or user.
Statistics
The technical storage or access that is used exclusively for statistical purposes. The technical storage or access that is used exclusively for anonymous statistical purposes. Without a subpoena, voluntary compliance on the part of your Internet Service Provider, or additional records from a third party, information stored or retrieved for this purpose alone cannot usually be used to identify you.
Marketing
The technical storage or access is required to create user profiles to send advertising, or to track the user on a website or across several websites for similar marketing purposes.
  • Manage options
  • Manage services
  • Manage {vendor_count} vendors
  • Read more about these purposes
View preferences
  • {title}
  • {title}
  • {title}
