Close Menu
reNEWSreNEWS
  • Home
  • Offshore Wind
  • Onshore Wind
  • Solar
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
Latest News

PODCAST: Is UK offshore wind back on track?

All-Energy 2026: Shanks bullish on UK clean power

GWEC, TÜREB launch wind partnership

LinkedIn Facebook X (Twitter)
LinkedIn Facebook X (Twitter)
  • Email Briefings
  • About
  • Advertise
  • Contact
reNEWSreNEWS
  • Home
  • Offshore Wind

    PODCAST: Is UK offshore wind back on track?

    May 13, 2026

    UK offshore wind pipeline reaches 93GW

    May 13, 2026

    Seaway7 completes Hai Long cable works

    May 13, 2026

    DEME names new jack-up vessel

    May 13, 2026

    Mubadala invests $325m into Hornsea 3

    May 13, 2026
  • Onshore Wind

    ENERCON to build Türkiye blade plant

    May 13, 2026

    ‘Fatality at South Korean wind farm’

    May 13, 2026

    Scottish onshore wind forum launches

    May 12, 2026

    ENOVA starts 30MW Hiddels repowering

    May 12, 2026

    Iberdrola buys 40MW Italian wind farm

    May 12, 2026
  • Solar

    VSB secures Sicily PV project approval

    May 13, 2026

    Matrix connects two Spanish renewable projects

    May 13, 2026

    Qualitas targets €10bn energy investments

    May 12, 2026

    Consultation opens for 49.9MW Barrons Solar

    May 12, 2026

    Great North Road solar nears decision

    May 11, 2026
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
LinkedIn Facebook X (Twitter)
reNEWSreNEWS
Home » Uncategorized » TenneT presses on with HKZ Beta platform installation
Offshore Wind

TenneT presses on with HKZ Beta platform installation

SaraBy SaraMarch 24, 20222 Mins Read
TenneT presses on with HKZ Beta platform installation

The installation of the second offshore transformer platform for the grid connection of the Hollandse Kust Zuid (HKZ) offshore can be carried out as planned, TenneT has confirmed.

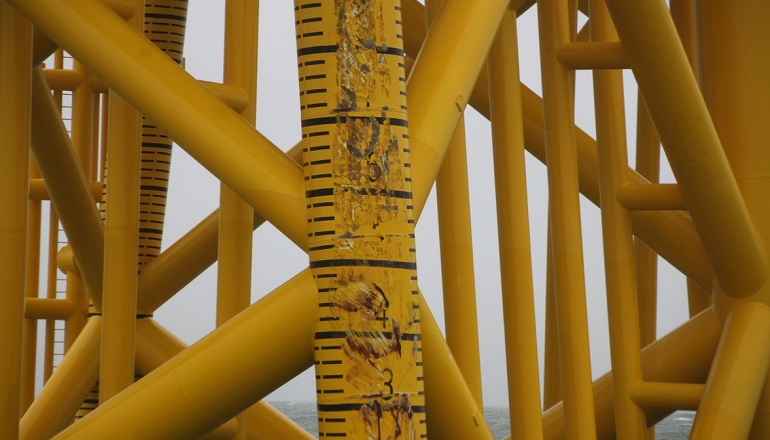

The grid operator has wrapped up investigations on the jacket (substructure) that was damaged in January during storm Corrie due to a collision with the adrift vessel Julietta D.

Advertisement

The investigation shows that the damage to the jacket is limited and the damaged parts can be repaired at a later stage after topside installation.

The Beta topside is being shipped to its destination in the North Sea and will be installed at the end of March or beginning of April.

On 31 January, the freighter Julietta D was adrift due to storm Corrie in the area where TenneT is building two transformer platforms, HKZ Alpha and Beta.

These transformer platforms are part of the offshore connection of the HKZ offshore wind farm being built by Vattenfall.

The cargo ship collided with the Beta jacket.

No people were working at the platform at the time.

The persistent stormy weather in February meant that inspections of the damage could not be carried out immediately.

In addition to the inspection of visible damage above water, underwater investigations were also carried out to determine any damage to the substructure.

This underwater investigation took more time due to relatively high waves and poor visibility.

The investigation now shows that the damage is limited to paint damage and a few dents on one of the legs of the platform and damage to one of the four landing platforms for working vessels.

Joris Engelen, TenneT’s platform project lead, said: “When designing and building our jackets, scenarios are taken into account that a ship of limited size may collide with the jacket.

“After the initial fright of the collision, we set up and implemented an extensive investigation plan in cooperation with the parties involved.

“The jacket is expected to be in operation for many years. We are therefore relieved that the inspections and the investigations show that we can install the top side of the transformer platform on the jacket safely and as scheduled.

“After the topside has been installed, the repairs of the damages on the jacket can be carried out.”

HKZ Beta Offshore Wind Tennet
Share. Facebook LinkedIn Bluesky Twitter Reddit Email Copy Link
Previous ArticlePGE, Orsted to host Baltica 2 and 3 supplier workshop
Next Article Drax supplies Allied Glass with Scots hydroelectricity

Related News

TenneT energises HKZ Alpha grid connection

March 31, 2022

TenneT reveals HKZ Beta damage

February 9, 2022

Engie Fabricom, Iemants confirm HKN platform job

June 9, 2020
Advertisement

Latest News

PODCAST: Is UK offshore wind back on track?

May 13, 2026

All-Energy 2026: Shanks bullish on UK clean power

May 13, 2026

GWEC, TÜREB launch wind partnership

May 13, 2026

ENERCON to build Türkiye blade plant

May 13, 2026
Advertisement

Advertisement

Company Profiles
  • Collett & Sons Ltd
  • Leask Marine
  • TGS
  • Seaway7
    Seaway7
  • LSP
    LSP Renewables
  • JDR Cable Systems Ltd
  • Full Circle Wind Services
  • EDF
    EDF
  • Brightwind
    BrightWind Limited
  • Bilfinger UK
reNEWS
LinkedIn Facebook X (Twitter)
reMIX | Company Profiles | Industry Events
Get in touch | Advertising with us | About reNEWS

© 2026 Lewis Business Media. All Rights Reserved.
Lewis Business Media, Suite A, Arun House, Office Village, River Way, Uckfield, TN22 1SL

Terms and Conditions | Privacy Policy | Cookie Policy

Type above and press Enter to search. Press Esc to cancel.

Manage Consent
To provide the best experiences, we use technologies like cookies to store and/or access device information. Consenting to these technologies will allow us to process data such as browsing behaviour or unique IDs on this site. Not consenting or withdrawing consent, may adversely affect certain features and functions.
Functional Always active
The technical storage or access is strictly necessary for the legitimate purpose of enabling the use of a specific service explicitly requested by the subscriber or user, or for the sole purpose of carrying out the transmission of a communication over an electronic communications network.
Preferences
The technical storage or access is necessary for the legitimate purpose of storing preferences that are not requested by the subscriber or user.
Statistics
The technical storage or access that is used exclusively for statistical purposes. The technical storage or access that is used exclusively for anonymous statistical purposes. Without a subpoena, voluntary compliance on the part of your Internet Service Provider, or additional records from a third party, information stored or retrieved for this purpose alone cannot usually be used to identify you.
Marketing
The technical storage or access is required to create user profiles to send advertising, or to track the user on a website or across several websites for similar marketing purposes.
  • Manage options
  • Manage services
  • Manage {vendor_count} vendors
  • Read more about these purposes
View preferences
  • {title}
  • {title}
  • {title}
