Close Menu
reNEWSreNEWS
  • Home
  • Offshore Wind
  • Onshore Wind
  • Solar
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
Latest News

PODCAST: Is UK offshore wind back on track?

All-Energy 2026: Shanks bullish on UK clean power

GWEC, TÜREB launch wind partnership

LinkedIn Facebook X (Twitter)
LinkedIn Facebook X (Twitter)
  • Email Briefings
  • About
  • Advertise
  • Contact
reNEWSreNEWS
  • Home
  • Offshore Wind

    PODCAST: Is UK offshore wind back on track?

    May 13, 2026

    UK offshore wind pipeline reaches 93GW

    May 13, 2026

    Seaway7 completes Hai Long cable works

    May 13, 2026

    DEME names new jack-up vessel

    May 13, 2026

    Mubadala invests $325m into Hornsea 3

    May 13, 2026
  • Onshore Wind

    ENERCON to build Türkiye blade plant

    May 13, 2026

    ‘Fatality at South Korean wind farm’

    May 13, 2026

    Scottish onshore wind forum launches

    May 12, 2026

    ENOVA starts 30MW Hiddels repowering

    May 12, 2026

    Iberdrola buys 40MW Italian wind farm

    May 12, 2026
  • Solar

    VSB secures Sicily PV project approval

    May 13, 2026

    Matrix connects two Spanish renewable projects

    May 13, 2026

    Qualitas targets €10bn energy investments

    May 12, 2026

    Consultation opens for 49.9MW Barrons Solar

    May 12, 2026

    Great North Road solar nears decision

    May 11, 2026
  • Other News
    • Energy Storage
    • Finance
    • Grid
    • People
    • reMIX
  • More
    • Company Profiles
    • Events
    • National Wind Energy Awards 2026
LinkedIn Facebook X (Twitter)
reNEWSreNEWS
Home » Uncategorized » SSE completes Coire Glas tunnel
Other News

SSE completes Coire Glas tunnel

reNEWS EditorialBy reNEWS EditorialAugust 9, 20243 Mins Read

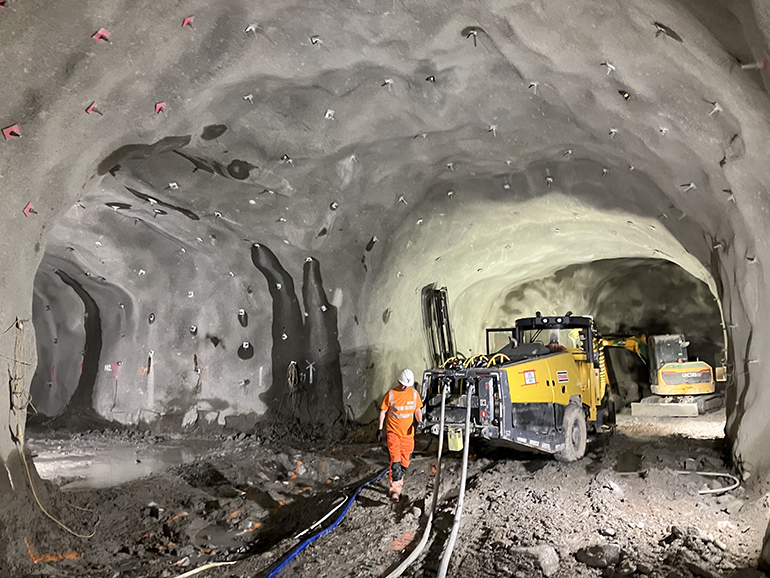

SSE completes Coire Glas tunnel

Exploratory tunnelling at the site of what would be the UK’s first large-scale pumped storage scheme to be developed in 40 years is now complete.

The completion of a 1.2km long exploratory tunnel is the latest milestone in SSE’s ongoing development of its 1.3GW Coire Glas project in the Scottish Highlands.

Advertisement

Located at Loch Lochy in the Great Glen, the scheme would be capable of delivering 30GWh of long duration electricity storage – enough to be able to provide firm, flexible renewable power for three million British homes for up to 24 hours non-stop, said the developer.

SSE Renewables hopes to make a final investment decision on the project in late 2025 or early 2026, allowing for main construction to commence in the second half of 2026, subject to being successful in the administrative allocation of an investable cap and floor mechanism.

Exploratory works at Coire Glas commenced in December 2022 and are being conducted by mining and tunnelling contractor Strabag UK.

In early 2023, SSE announced a £100m investment boost to further develop the storage facility to include the construction of a major exploratory tunnel as part of a package of site investigation works.

SSE’s technical partners, Stantec and COWI, have designed and supervised the unique and complex ground investigation programme which is being delivered by Strabag.

The works included the creation of a tunnel approximately five metres high and four and a half metres wide which cuts into the hillside around the proposed location of the underground complex.

Construction of the tunnel will allow the project team to gather accurate information on the geological conditions to inform the detailed design for the main works.

Now that tunnel construction is complete, a programme of exploratory drilling and testing will continue for the next three months to further investigate the ground in the area of the proposed underground powerhouse excavations.

Mike Seaton, SSE Renewables Director of Development for Coire Glas, said: “Completing the tunnelling is testament to the hard work and dedication of everyone involved and a positive step forward in de-risking the project.

 “The works progressed to plan, and samples of the materials excavated from within the hillside are currently being analysed.

“This phase of the project is an engineering challenge in itself and we are learning a huge amount as we progress the works.

“The findings of the tunnelling works, alongside our wider site ground investigation works completed by Fugro in December 2023, will be used to inform the final design, including the detailed design of underground structures, and will be a key consideration in any final decisions related to the project.”

Business director, energy, at Stantec John Ord said: “The Stantec team has thoroughly enjoyed working on this stage of the Coire Glas project, delivering award winning work alongside COWI, Strabag, and SSE Renewables.

“We look forward to continuing our support as it moves into the next phase, defining rock quality more than a kilometre inside the mountain.

“This important work will inform the design of the main pumped storage scheme, moving the project closer to offering a huge boost for the UK’s renewable energy storage.”

COWI’s managing director in the UK Andy Sloan added: “At COWI we are delighted to have reached the important milestone of the end of the tunnelling phase for the exploratory tunnel.

“The joint Stantec/COWI site team have worked tirelessly with SSE Renewables and Strabag to reach this point and collaboration has been excellent.

“The Stantec/COWI team will now move on to supervise the underground drilling, which includes complex testing rarely seen in the UK.”

Share. Facebook LinkedIn Bluesky Twitter Reddit Email Copy Link
Previous ArticleVestas wins 41MW Spanish order
Next Article Manufacturer to unveil turbine tech

Related News

SSE wins award for hydro project

September 10, 2025

Work starts at SSE Renewables Scottish hydro project

December 14, 2022

SSE reveals Coire Glas hydro tender shortlist

June 1, 2022
Advertisement

Latest News

PODCAST: Is UK offshore wind back on track?

May 13, 2026

All-Energy 2026: Shanks bullish on UK clean power

May 13, 2026

GWEC, TÜREB launch wind partnership

May 13, 2026

ENERCON to build Türkiye blade plant

May 13, 2026
Advertisement

Advertisement

Company Profiles
  • TGS
  • Ørsted
  • Navantia Seanergies
    Navantia Seanergies
  • Natural Power
    Natural Power
  • LSP
    LSP Renewables
  • JDR Cable Systems Ltd
  • Full Circle Wind Services
  • EEW
    EEW Special Pipe Constructions GmbH
  • EDF
    EDF
  • Brightwind
    BrightWind Limited
reNEWS
LinkedIn Facebook X (Twitter)
reMIX | Company Profiles | Industry Events
Get in touch | Advertising with us | About reNEWS

© 2026 Lewis Business Media. All Rights Reserved.
Lewis Business Media, Suite A, Arun House, Office Village, River Way, Uckfield, TN22 1SL

Terms and Conditions | Privacy Policy | Cookie Policy

Type above and press Enter to search. Press Esc to cancel.

Manage Consent
To provide the best experiences, we use technologies like cookies to store and/or access device information. Consenting to these technologies will allow us to process data such as browsing behaviour or unique IDs on this site. Not consenting or withdrawing consent, may adversely affect certain features and functions.
Functional Always active
The technical storage or access is strictly necessary for the legitimate purpose of enabling the use of a specific service explicitly requested by the subscriber or user, or for the sole purpose of carrying out the transmission of a communication over an electronic communications network.
Preferences
The technical storage or access is necessary for the legitimate purpose of storing preferences that are not requested by the subscriber or user.
Statistics
The technical storage or access that is used exclusively for statistical purposes. The technical storage or access that is used exclusively for anonymous statistical purposes. Without a subpoena, voluntary compliance on the part of your Internet Service Provider, or additional records from a third party, information stored or retrieved for this purpose alone cannot usually be used to identify you.
Marketing
The technical storage or access is required to create user profiles to send advertising, or to track the user on a website or across several websites for similar marketing purposes.
  • Manage options
  • Manage services
  • Manage {vendor_count} vendors
  • Read more about these purposes
View preferences
  • {title}
  • {title}
  • {title}
